What Approval Workflow Compliance Actually Requires

Deep Singh
Author: Deep Singh
August 19, 2026
11 min read

The short answer

Hand stamping contract approval in office

A compliant approval workflow stops the action until the approval exists. The contract can't be signed, the supplier can't be paid, and the code can't ship until a named person has approved it in the system, with the date, the document version and a reason recorded at that moment.

That's the line between a gate and a story. A gate produces evidence. Approvals collected after the fact produce a story you rebuild from email, and an auditor will treat it that way.

To meet that bar you need four things:

  • A timestamped record of every decision that can't be edited afterwards.
  • Permissions that stop anyone approving their own request.
  • A reason tied to a specific policy or rule, not just an "Approved" click.
  • Retention and export in a format an auditor can open and check.
Pro tip
Find any process where the action can happen before the approval is recorded, and close it first. If someone can sign a contract or send a customer notice and get sign-off later, you don't have an approval workflow. You have paperwork.

Where approval workflows are worth the effort

You need a formal workflow anywhere a regulator, auditor or your own policy expects proof that a check happened. Think of a new cleaning contractor being added to the supplier master file, a sales director offering 90-day payment terms when policy says 30, a "clinically proven" line on a supplement label, or a Friday-night hotfix to the billing database.

Each workflow has a few fixed roles. The submitter starts it. One or more approvers judge it against policy. A signer executes it if a signature is needed. An observer can read but not act. Higher-risk items often add a compliance or legal reviewer.

Two patterns cover most cases:

  1. Sequential contract approval. The submitter uploads the contract and a risk rating. Legal reviews first. Finance reviews only after legal clears it. The signer goes last.
  2. Parallel conflict-of-interest review. An employee discloses a relationship. Compliance and their manager review at the same time, and both must clear it before HR closes the file.

What the rules actually ask for

Auditors don't ask whether a review probably happened. They ask for the record. Some rules spell out what that record must look like, and they're a useful benchmark even if they don't apply to you.

FDA's rule on electronic records, 21 CFR 11.10, is the clearest example. It requires "secure, computer-generated, time-stamped audit trails" that record entries and actions that create, modify or delete records, and it says "record changes shall not obscure previously recorded information." It also requires authority checks so only authorised people can sign or alter a record.

If you're a US public company, approvals over spending, journal entries and contracts usually sit inside the internal controls your auditors test under Sarbanes-Oxley section 404. Different rule, same question: can you show who approved it, and that they were allowed to?

Done well, a formal workflow also pays off day to day:

  • Evidence that holds up in an internal investigation as well as an external audit.
  • The same policy applied by every team, instead of each manager reading the rules their own way.
  • Real separation of duties, so no one person submits and approves the same thing.

You'll also see fewer email chains chasing signatures and fewer requests bounced back for missing information, because the form won't submit without it.

The controls to put on your requirements list

Whether you're writing an RFP or configuring a tool you already own, test for each of these. Miss one and the workflow will look compliant but won't be able to prove it.

A record nobody can rewrite

Every submission, review, edit, approval and rejection gets a timestamp and the reviewer's identity, and neither can be changed later. When a document is signed, the record should lock and keep the signer's name, email and the exact time.

Hand locking filing cabinet representing audit trail

If anyone edits a record after approval, the change should be visible and traceable to them. The original stays readable underneath.

A reason, not just a status

"Approved" tells an auditor nothing. The reviewer should record which policy they applied, what evidence they relied on and why it was enough.

Pro tip
Split the reason field into three parts: the policy or rule cited, the evidence attached (a document, a screenshot, an earlier approval), and one line on why that evidence satisfies the rule. A blank notes box invites answers that fall apart under questioning.

Separation of duties built into permissions

The person who submits a request must not be able to approve it. Enforce that in the system's permissions; a policy that says so isn't enough on its own.

Version control

If a contract changes during review, the system must show which version each approver saw. Otherwise legal approves draft 3, sales tweaks the liability cap overnight, and draft 5 is what gets signed. Nobody notices until the claim arrives.

Required fields, timers and routing

Reviewers can't submit a decision until the required fields are filled in, for example the policy reference, the risk rating and the supporting files.

A request that sits untouched for 48 hours should escalate on its own. High-risk requests should route to extra reviewers automatically, based on what was submitted, rather than on someone's judgement at triage.

Finally, keep records for as long as your retention rules require, in a format an auditor can actually use.

How to build one in six steps

Map the process before you configure anything. Teams that jump straight to the tool tend to rebuild it within a year.

  1. List every decision that needs approval (contract exceptions, disclosures, system changes) and what starts each workflow.
  2. Decide what a reviewer must see before approving, such as a risk rating, a policy reference and the supporting documents.
  3. Set up roles, escalation timers and the block that stops execution until approval exists.
  4. Connect e-signature, document storage and sign-in, so the approval and the signature share one record.
  5. Pilot one high-value process, such as supplier onboarding, alongside the old way for one full cycle.
  6. Measure time to approval, how often requests bounce back, and how good the audit export is. Adjust, then roll out the next process.

At submission, capture the requester and their department, the policy or rule that applies, a risk rating (low, medium or high), the supporting files and the proposed effective date.

Before you call the pilot a success, test it like an auditor would:

  • Can you export a complete record for any single approval in under five minutes?
  • Does the system refuse an attempt to edit a record after approval?
  • How long do standard and high-risk requests take, and does that meet the target you set?
  • How many requests needed a manual override? If it's more than the odd one, your decision rules need work before you scale.

Sequential or parallel: pick by risk

Sequential approval sends a request to reviewers one at a time, and each sees the earlier decisions. It's slower, but the audit story is cleaner, because reviewer B saw reviewer A's reasoning before adding their own. Use it when order matters, like legal before finance on a contract exception.

Parallel approval goes to several reviewers at once. It's faster and suits lower-risk items, or cases where reviewers judge different things independently.

Keep approver and signer as separate roles. The approver clears the decision; the signer executes it. Never let the signature happen before the approval is recorded, because that ordering is exactly how approvals end up being collected after the fact.

Delegation needs its own rules. When an approver is away, the delegation should have an end date, show up in the log as a separate event, and lapse when they return.

Pro tip
Make every delegation expire automatically. Seven days is a sensible default for most teams. Open-ended delegation is how approval authority drifts to people who were never meant to hold it.

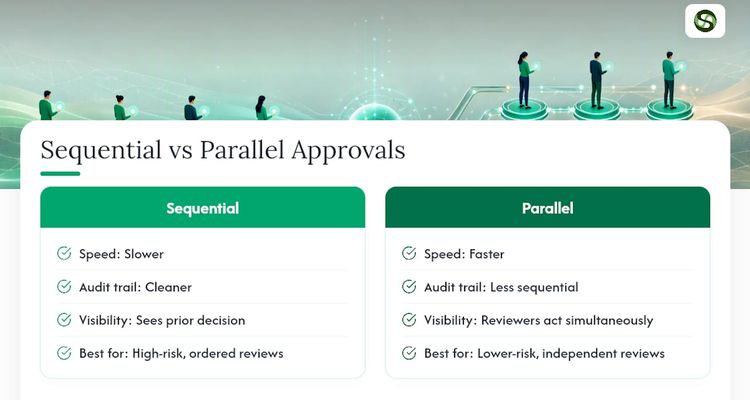

Sequential vs. Parallel Approvals: Which Pattern Fits? — overview diagram

What auditors check in an approval record

Expect them to look for the reviewer's identity and role, the timestamp, the decision, the reason tied to a policy, the attached evidence, which version of the document was reviewed, and the full history.

The usual finding isn't a bad decision. It's a decision you can't prove happened the way the record says. Once you're rebuilding the trail from inboxes, you've already lost most of its weight.

Export format matters more than teams expect. CSV or JSON with a timestamp on every field works for system reconciliation. A PDF pack with the request, each approval, the attachments and the relevant policy text works better for a person reviewing one case.

Pro tip
Build one export that bundles the whole story for a single approval. When an auditor asks about a specific decision, you should be able to hand it over in minutes, not piece it together from three systems.

The integrations that make the gate real

A workflow diagram means nothing if the underlying system lets people go around it. The integrations below close the usual gaps:

  • E-signature, so the signature request goes out automatically once approval clears, with no manual handoff.
  • Document storage, so the approved version and the signed version stay linked.
  • Single sign-on (SAML or OIDC), so reviewer identity is verified rather than typed into a form.
  • Ticketing or ERP, so approvals for purchases and IT changes flow into the systems that execute them.

Ask vendors to show four things working: timestamps on every status change, field-level change history, delegation logs kept separate from approvals, and an export that pulls a full record on demand.

Where approval workflows usually break

Almost every failure falls into one of these patterns:

  • Approval after the action. The contract was signed or the campaign launched before anyone approved it. This is the worst one, because your audit trail becomes a reconstruction.
  • Incomplete requests approved anyway, because the form didn't insist.
  • Delegations that never expire.
  • One version approved, a different one signed.
  • Approvals living in email and spreadsheets instead of one system.

Fix approvals-after-the-action first; that's a system problem, not a training one. Then sort out version control and required fields. After that, look at the timestamps. Twenty approvals from one manager between 4:50 and 5:00pm on the last day of the quarter? Nobody read those.

Where ExpiryEdge fits

Many approvals are tied to a date: a contract that auto-renews unless someone decides by the notice deadline, a supplier certificate that must be re-checked before it lapses, a licence that needs sign-off before renewal. ExpiryEdge handles that date-driven side.

You record the item, its deadline and the person responsible. ExpiryEdge reminds them by email, SMS, WhatsApp, Slack or Teams, escalates to a manager if the date gets close with no action, collects the renewed document, and keeps an exportable audit trail of every reminder and response. It isn't an e-signature tool, so pair it with the one you already use.

Expiryedge

Roll it out one process at a time

Start with the process that carries the clearest audit risk, usually supplier onboarding or contract exceptions. Run it alongside the old way for one full cycle before you switch anything off.

Expect pushback on the mandatory reason field. Reviewers will call it busywork. Tell them the truth: two years from now, when someone asks why they approved that supplier, those two lines are the only thing standing between them and an awkward meeting. That lands better than any training deck.

A practical next step: pick one high-risk process, run a 30-day pilot, and test it against the checks above (export time, edit refusal, time to approval). If renewal and expiry deadlines are part of it, you can try ExpiryEdge free for 14 days, no credit card needed.
